Total story points
See your team’s total story workload to support better estimates and planning.
Total story points is the sum of the story points of the stories in a group, such as a sprint, a workflow step, a list on the Everything page, or a timebox. Each story's points come from its size, so the total shows how much work a group holds rather than how many stories it has.

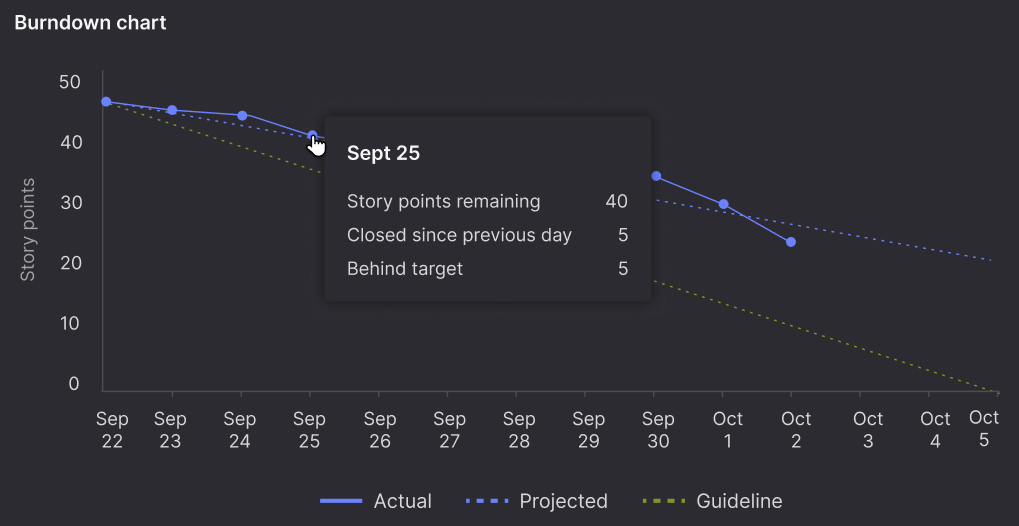

A total shows the work in a group as it stands now. To see how many story points a team completed in each week, month, or sprint, use Story throughput. To follow the story points left in a single sprint day by day, use a burndown chart.
Where total story points appear
Sprints
Each sprint shows its total story points:
- Backlog: In the sprint's header on a Scrum team's Backlog. Active and completed sprints show a single total. Future sprints show the planned total and the projected total, for example, '18 / 28'. For more details, see Projected sprint capacity.

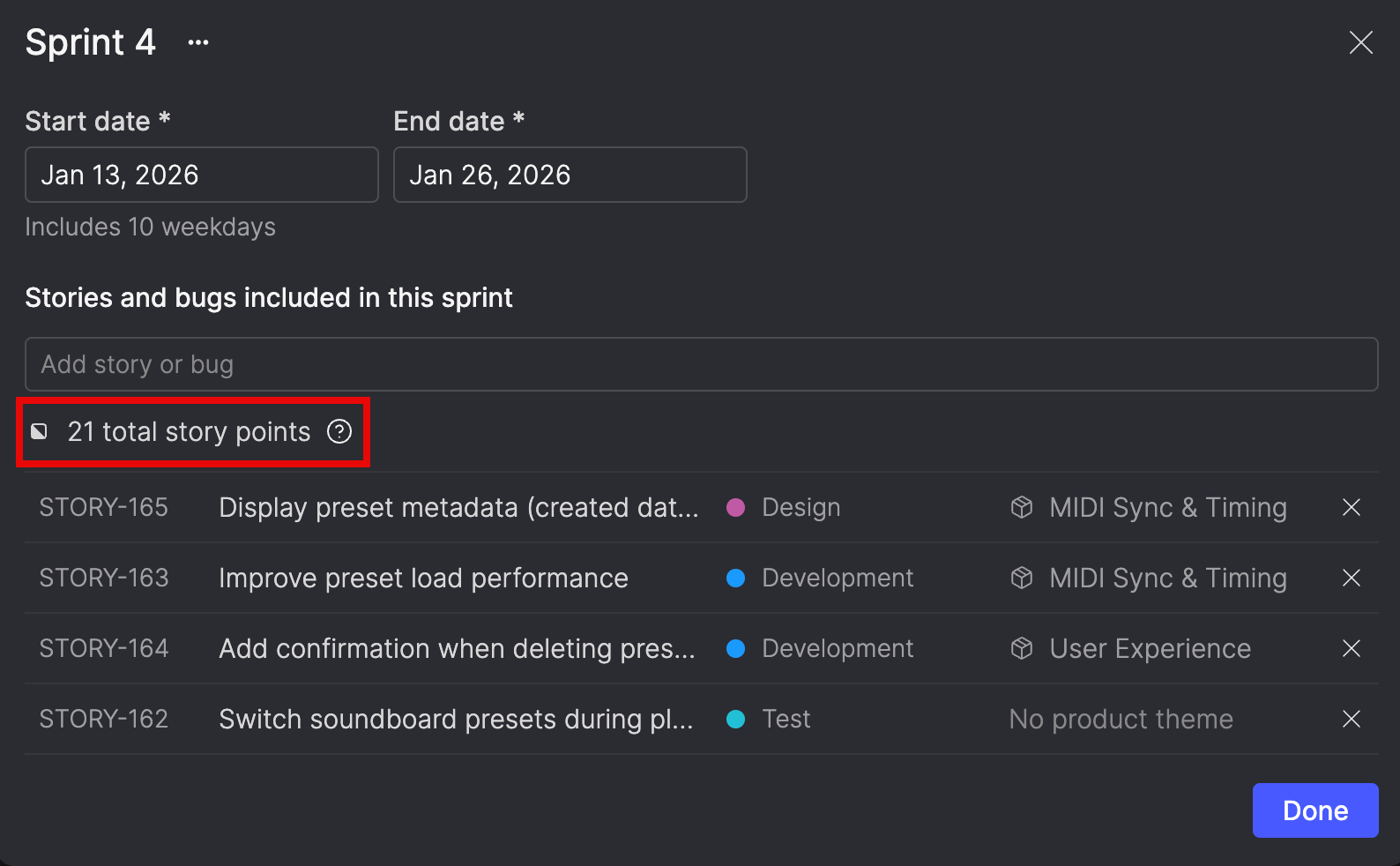

- Sprint details: Above the list of stories and bugs in the ‘Sprint details’ dialog. Active and completed sprints show a single total, for example, ‘50 total story points’. Future sprints show the planned and projected totals and how full the sprint is, for example, ‘28 planned / 26 projected total story points (108% filled)’.
- Sprint calendar: On each sprint on the Sprint calendar, when its total is more than 0.
In progress pages

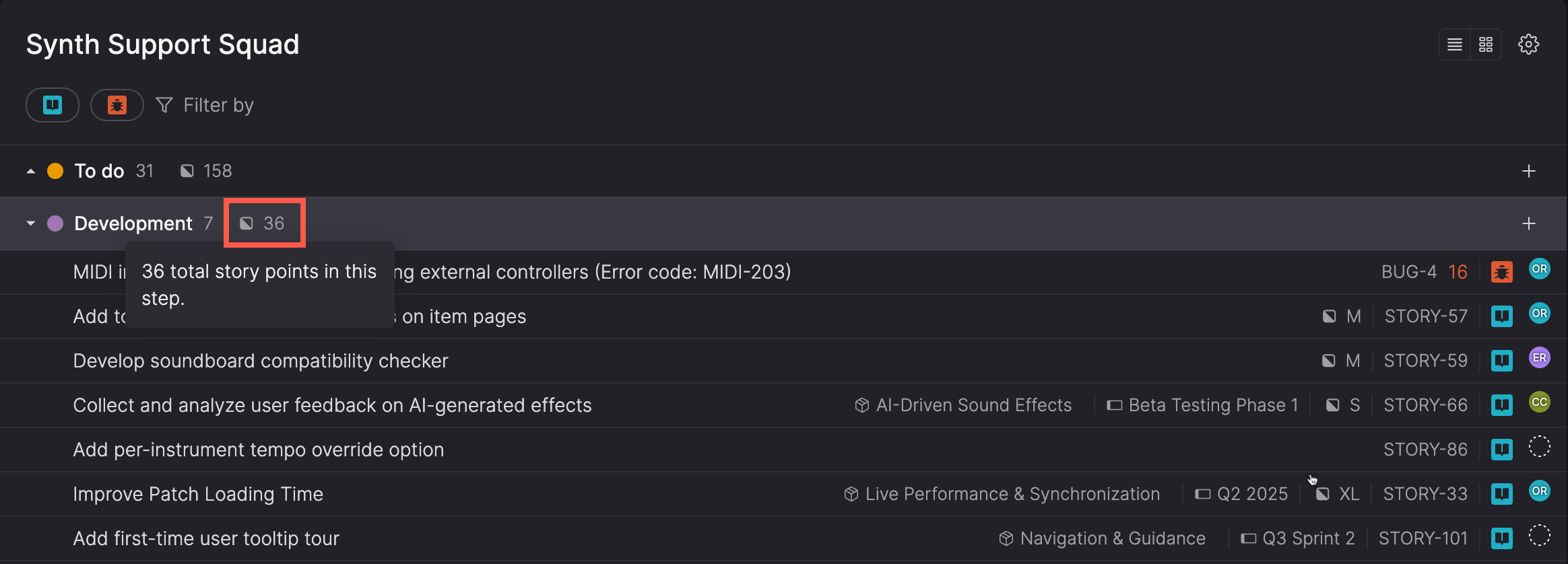

When total story points are turned on, each workflow step on a team's In progress page shows its total next to its item count, in both list and board views. A step with a total of 0 doesn't show one.
Hover over a step's total to see what it covers, for example, '13 total story points in this step.' When filters are applied, the message starts with 'Filter applied'.
On a Kanban team's In progress page, a step's total includes every story in the step, even when the step shows only 20 of its items.
Everything page

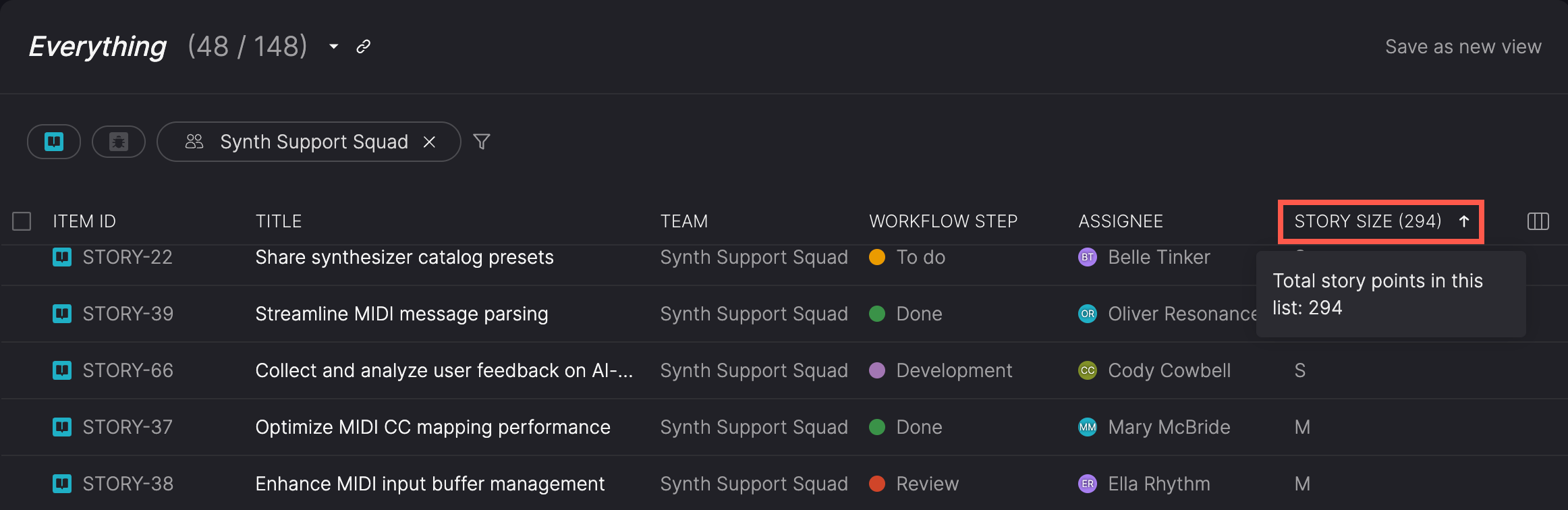

When the Everything page is filtered to a single team and the 'Story size' column is shown, the column header shows the total for the stories in the list, for example, 'Story size (1270)'. Hover over the header to see 'Total story points in this list'. If the total is 0, the header doesn't show one.
Timelines and timeboxes
When every story and bug in a timebox is on the same team's backlog, the timebox shows that team's total:
- On a timeline: In parentheses after the timebox's name, for example, 'Tags Mark II (20)'. Hover over it to see the team, for example, '20 total story points for team Vancouver'.
- On the timebox's details page or dialog: Above the list of stories and bugs.
If any item in the timebox is on another team's backlog or has no team, the timebox doesn't show a total, even when the timeline is filtered to one team. A timebox with a total of 0 doesn't show one either.
Show or hide total story points
The totals on In progress pages are a view setting. List view and board view each have their own setting, and your choice applies only to you, on that team. To show or hide them, select or clear Total story points in the view's Settings (gear) menu. For more details, see list and board view settings for Scrum and Kanban teams.
Totals in other places don't have a setting.
How total story points are calculated
Each size has a set number of story points:
| Size | Story points |
|---|---|
| XXS | 1 |
| XS | 2 |
| S | 3 |
| M | 5 |
| L | 8 |
| XL | 13 |
| XXL | 21 |
What's counted
Totals count only stories, not bugs. They include stories in 'Done' steps and stories marked as outliers.
Stories in 'Won't do' don't count toward sprint or timebox totals. On the Everything page, they count unless you filter them out. On an In progress page, the 'Won't do' step shows a total of its own.
Unsized stories
An unsized story counts as the team's average story size, so totals include it before anyone sizes it. Atono works out the average from the team's sized stories within its cycle time window, and rounds it to a size's point value. If the team has no sized stories in that window, each unsized story counts as 1 point. Totals don't mark which values are estimates.
Example: A team's sized stories within its cycle time window are S (3), M (5), L (8), and XL (13). Their average is 7.25 points, which rounds to L, so each unsized story on the team counts as 8 points. A workflow step with one of each of those stories and one unsized story has a total of 37 points.
Moving a story to another team clears its size, so it counts as the new team's average until someone sizes it again.
Story throughput estimates unsized stories differently, so the same story can count for a different number of points there. For more details, see Missing story point estimates.
How filters affect totals
Totals on In progress pages and the Everything page count only the stories that match your filters. Totals on sprints and timeboxes always count every story in the sprint or timebox, even when the Backlog or timeline is filtered.
The estimate for unsized stories always uses the team's whole cycle time window, whatever filters you apply.
Updated 17 days ago
